Case details
MESSERS: KOTA SEJARAH
VESSEL:
M/V:KOTA SEJARAH
PORT:
M/V:KOTA SEJARAH
DATE:
On/around 20th-Oct-2021
DEPT: DECK
According to the instructions of the ship owner, Shanghai Yizhou
Shipping Co., LTD., our company, assigned 6 people to the Mingdong
wharf of Shanghai Waigaoqiao Phase 5 for emergency repair of the
top mast of the bridge. 4 engineers went on board for repair, and

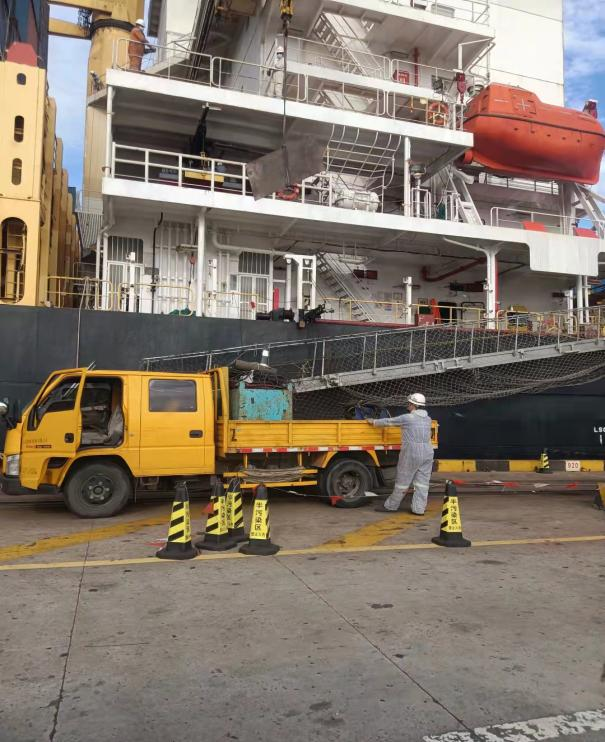

2 people cooperated at the wharf. Due to the tight time and large
amount of work, in order not to affect the normal sailing of the
ship, our company discussed with the ship owner and reached an
emergency righting, reinforcement and repair, so as not to affect
the normal sailing of the ship. The repair process is as follows:
According to the instructions of the ship owner, Shanghai Yizhou
Shipping Co., LTD., our company, assigned 6 people to the Mingdong
wharf of Shanghai Waigaoqiao Phase 5 for emergency repair of the
top mast of the bridge. 4 engineers went on board for repair, and
2 people cooperated at the wharf. Due to the tight time and large
amount of work, in order not to affect the normal sailing of the
ship, our company discussed with the ship owner and reached an
emergency righting, reinforcement and repair, so as not to affect

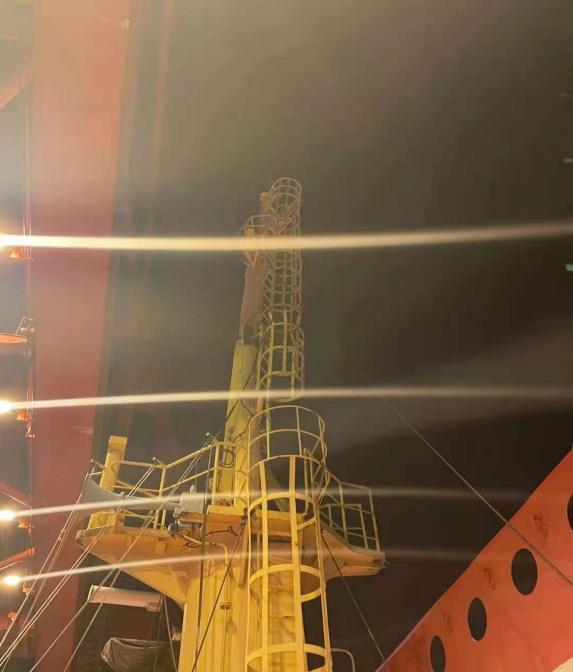

the normal sailing of the ship. 14:10 is the isolation vehicle

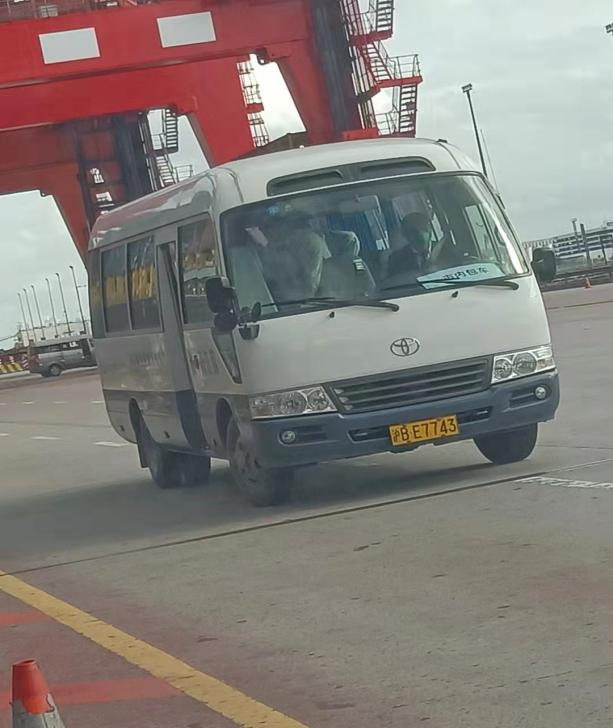

HuBE7743 transportation closed-loop personnel, 14:20 vehicle
HuEEW123 is the material and tool transport vehicle of our
company. There is no contact or communication in the whole
process, and all communication is through mobile phones. The
repair process is as follows:

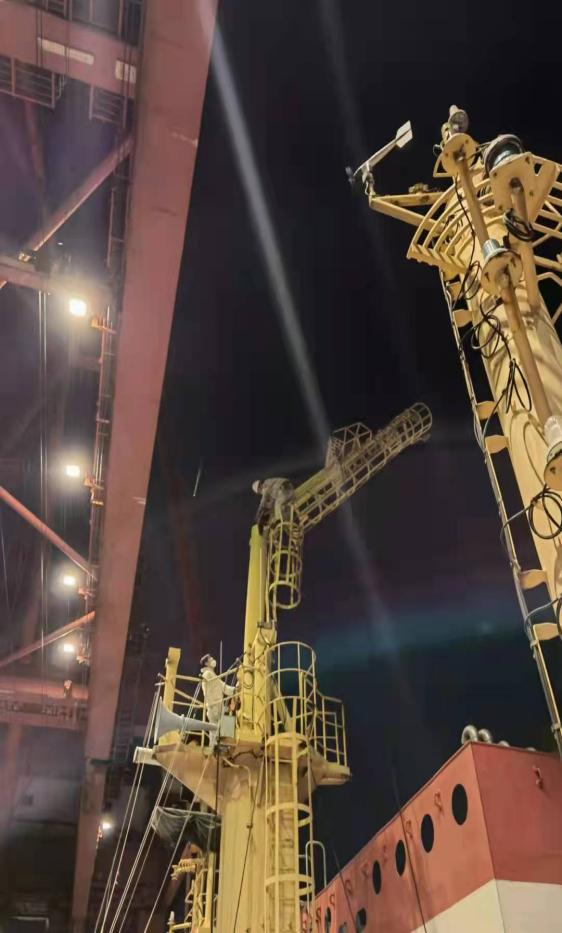

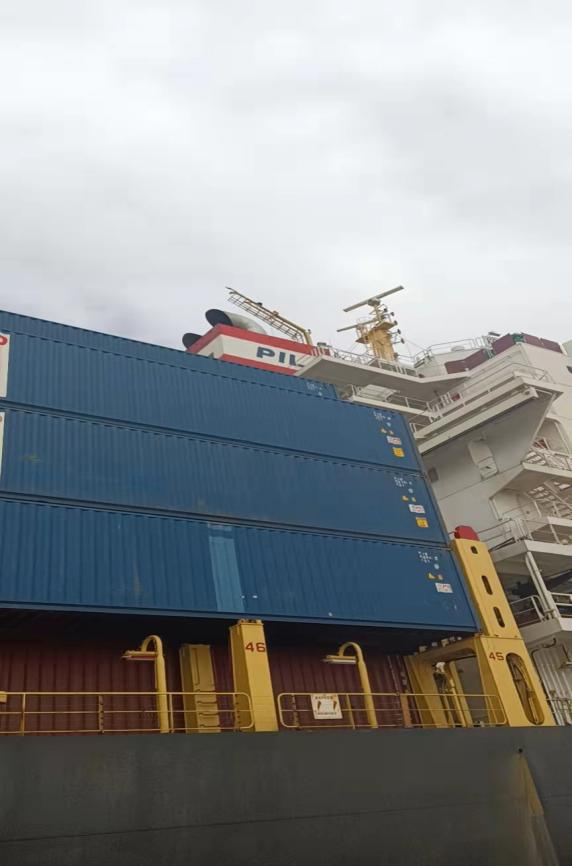

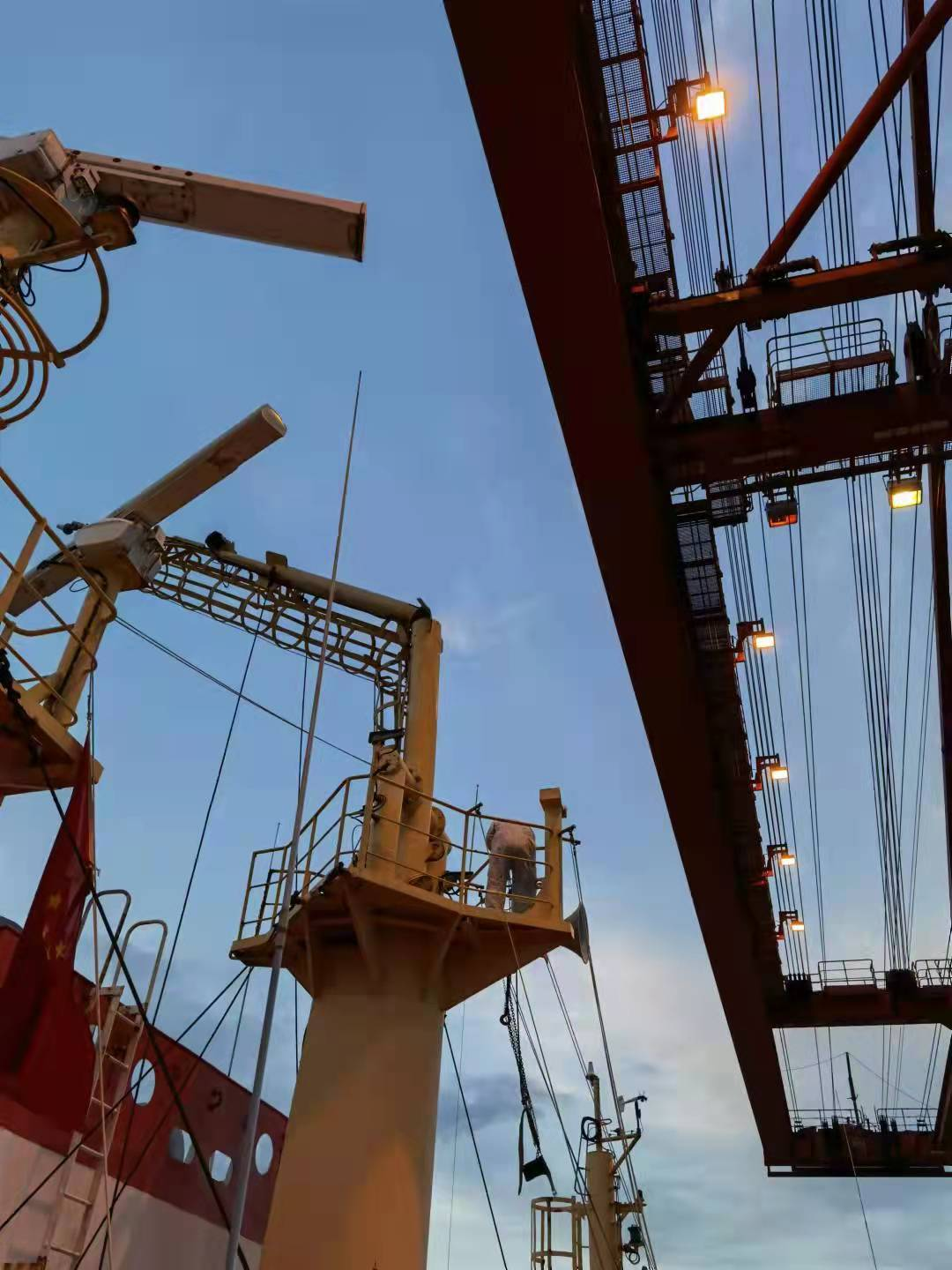

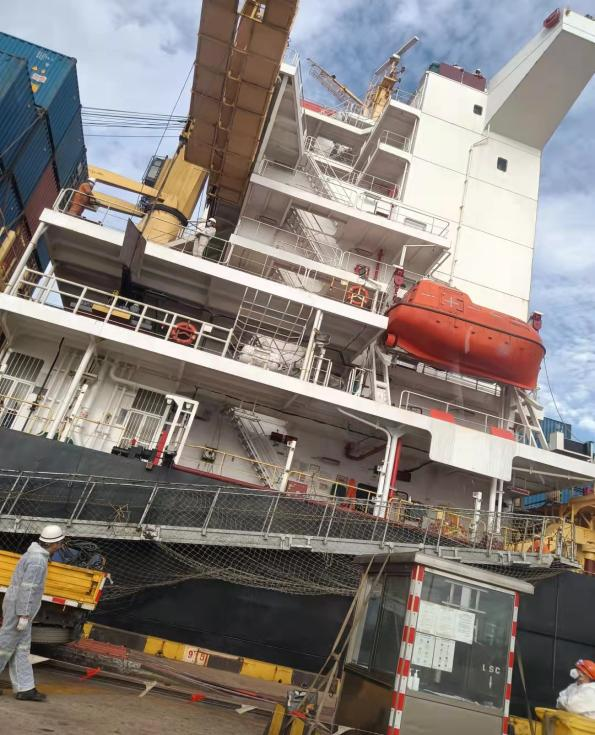

15:00 photos for our shore and scene survey of damage photos, and
then make corresponding preparations;

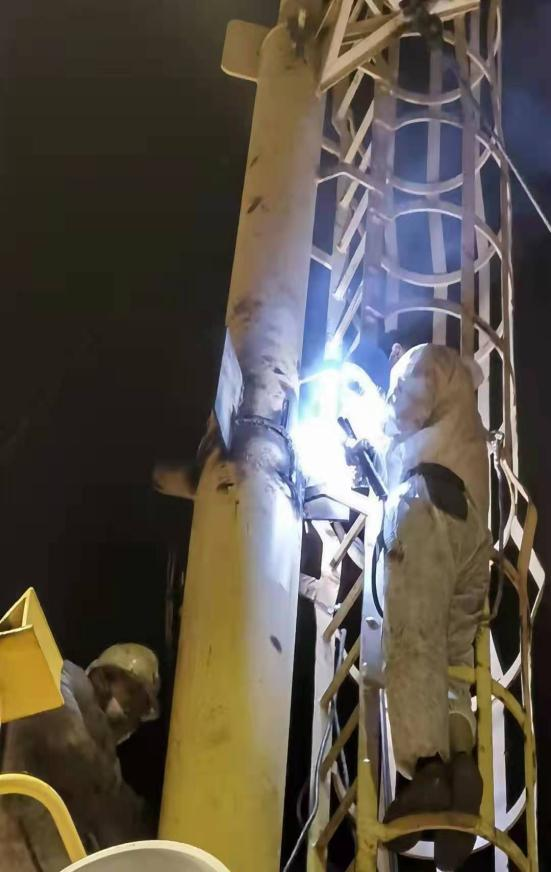

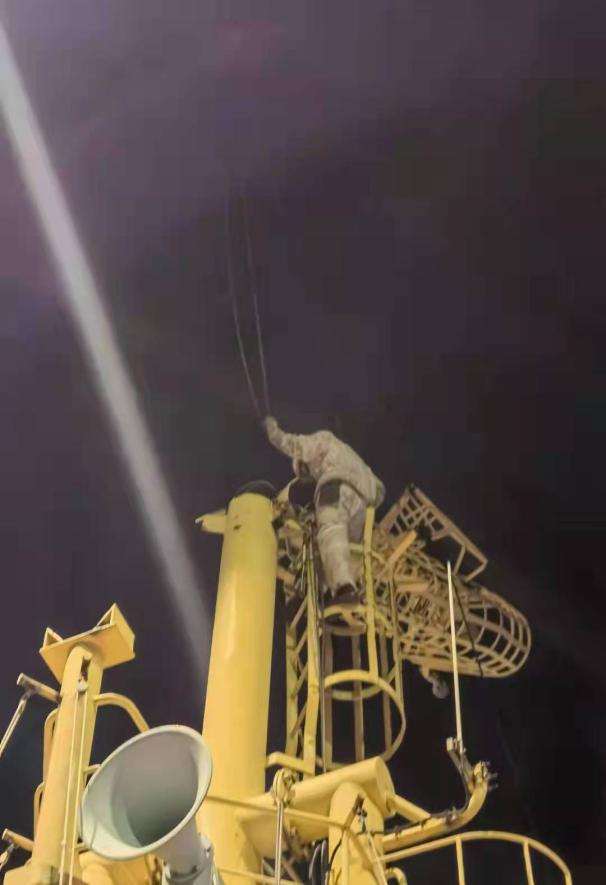

21:30 Through the efforts of our engineers, with the cooperation

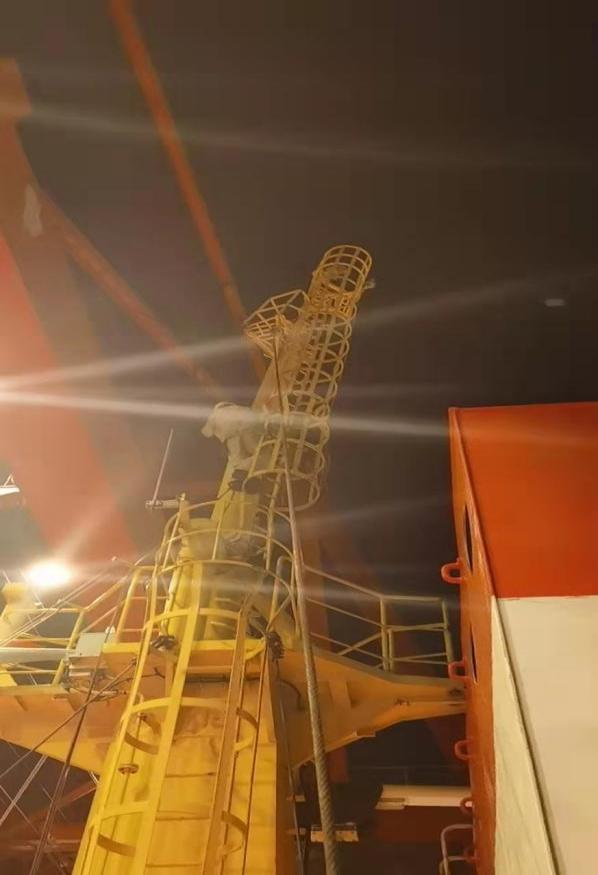

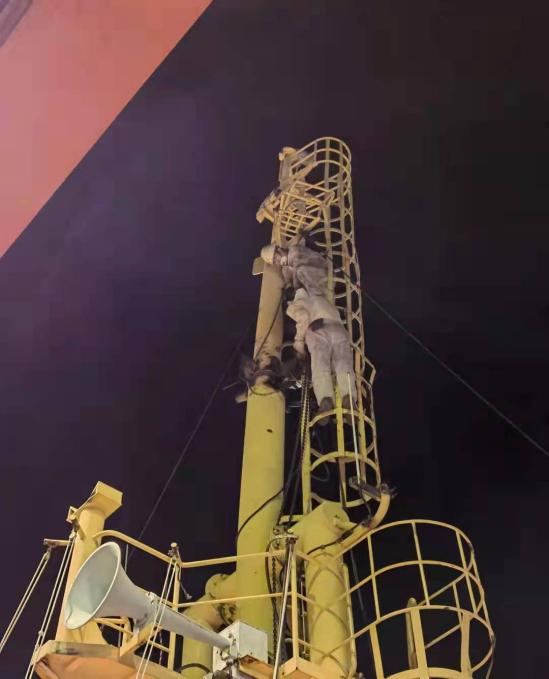

of the wharf gantry crane, the big mast was finally righted by
using the hoist;

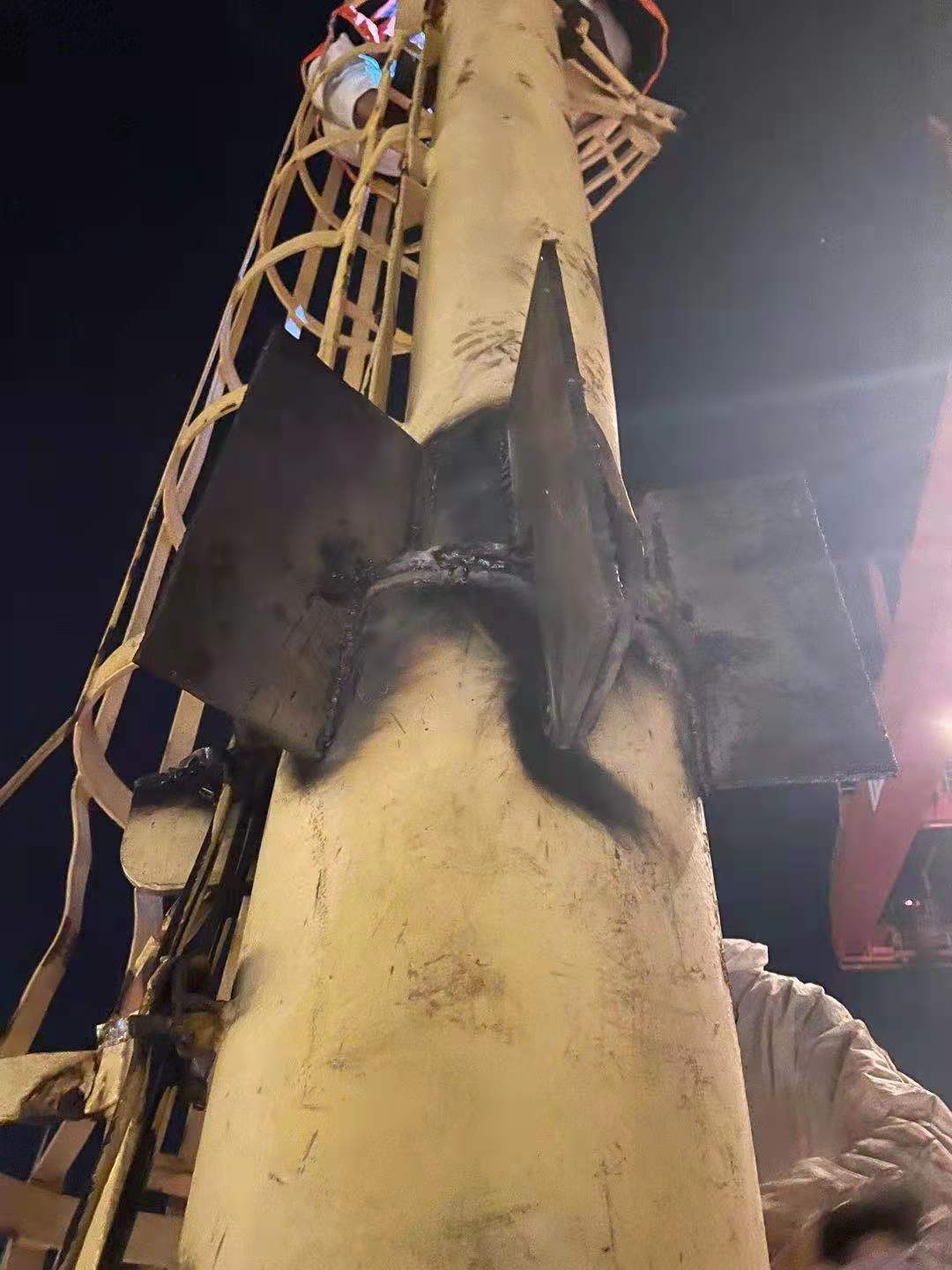

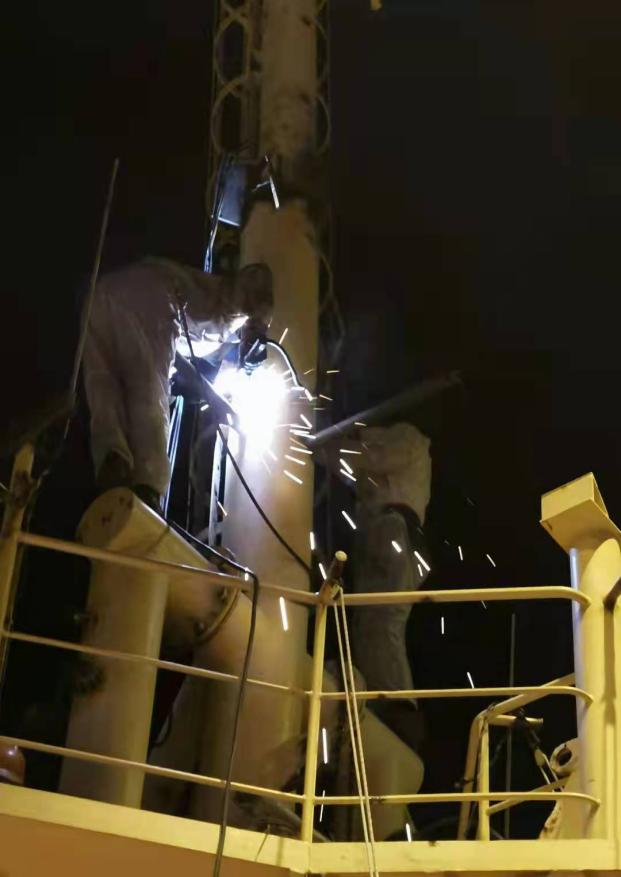

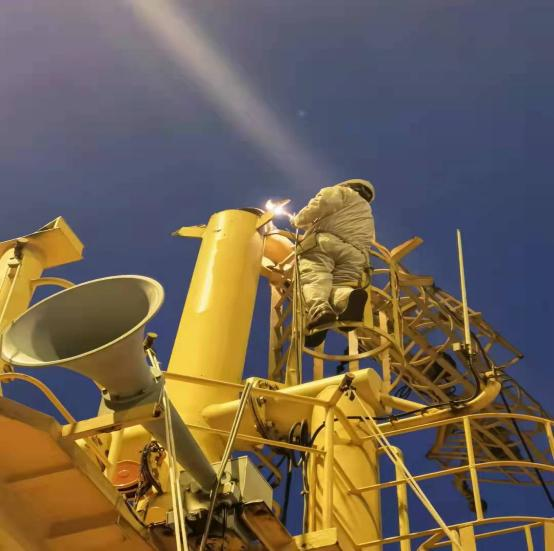

At 00:20, cut the bending part of the mast, fill the cut part, and

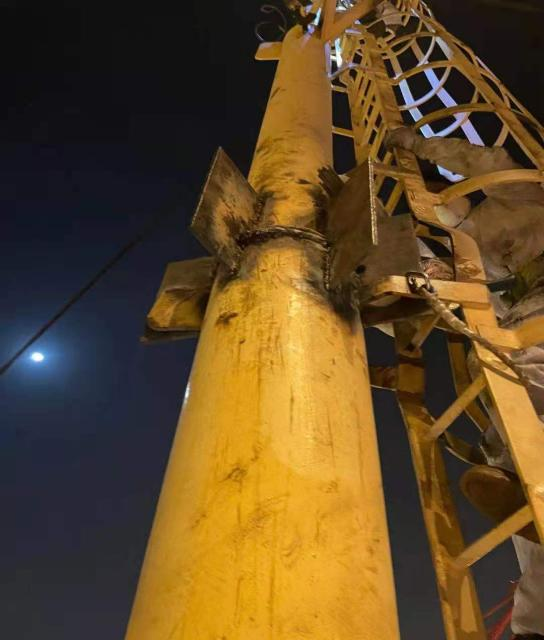

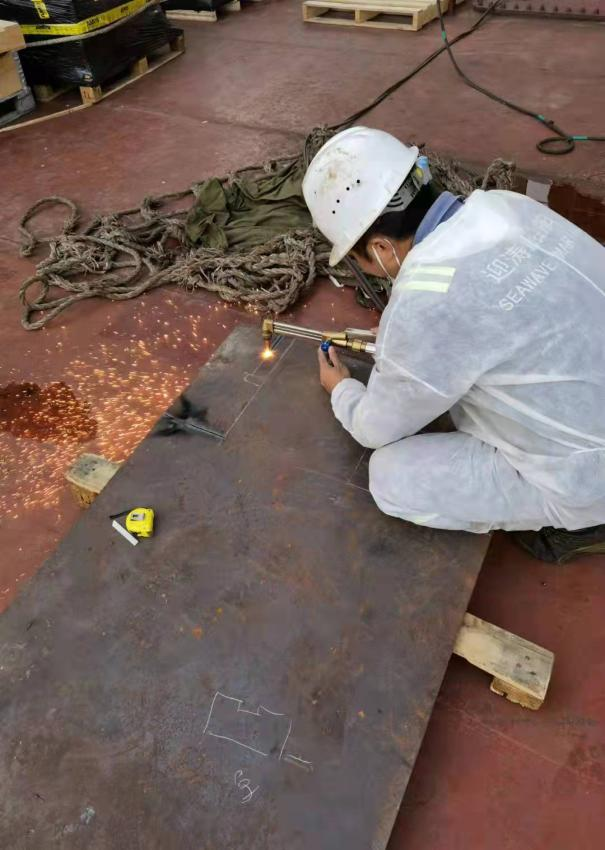

weld the new ribs. According to the requirements of the ship, weld
2 more ribs instead of the original 3 to further strengthen the
stability and safety of the big mast.

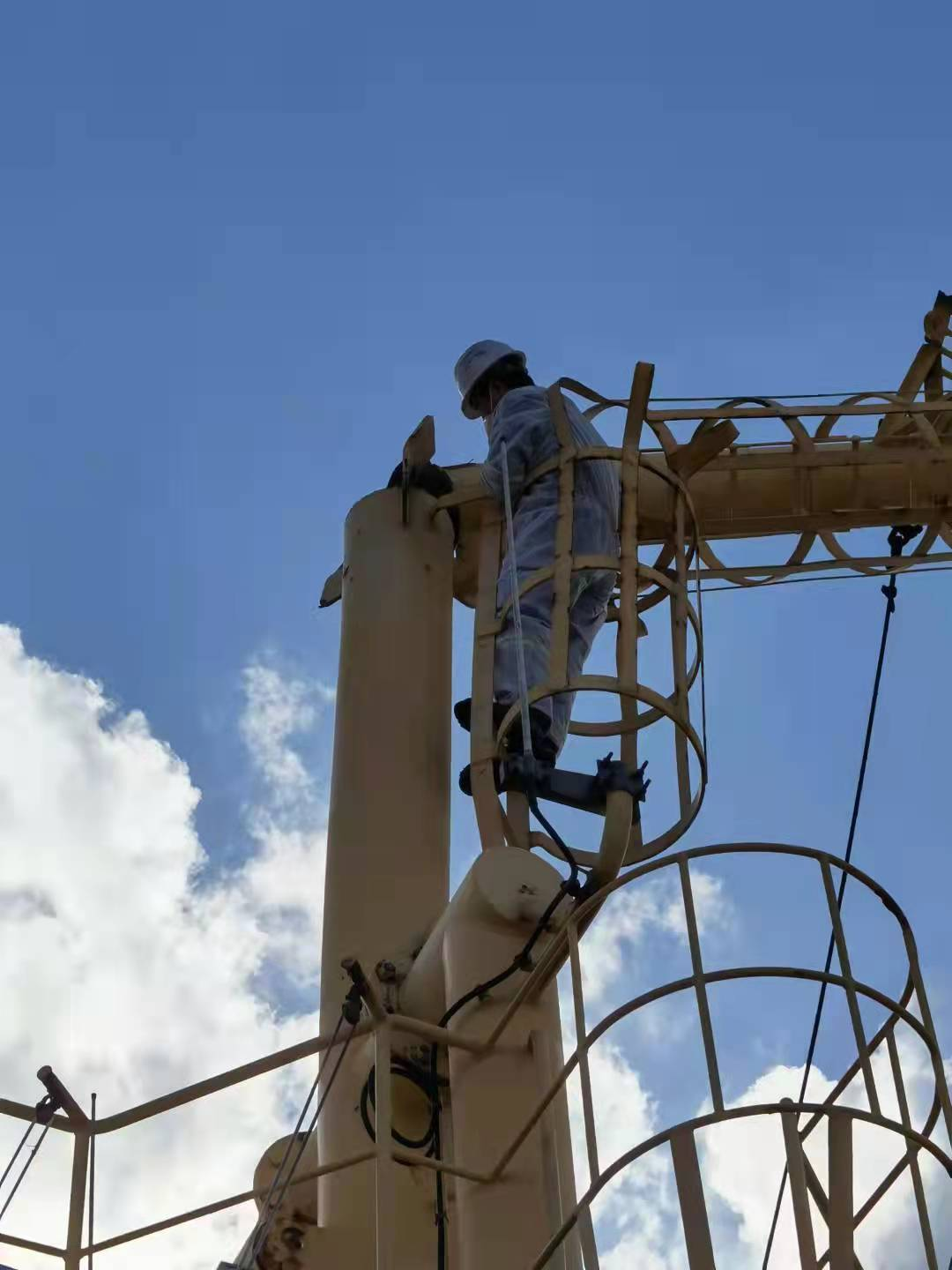

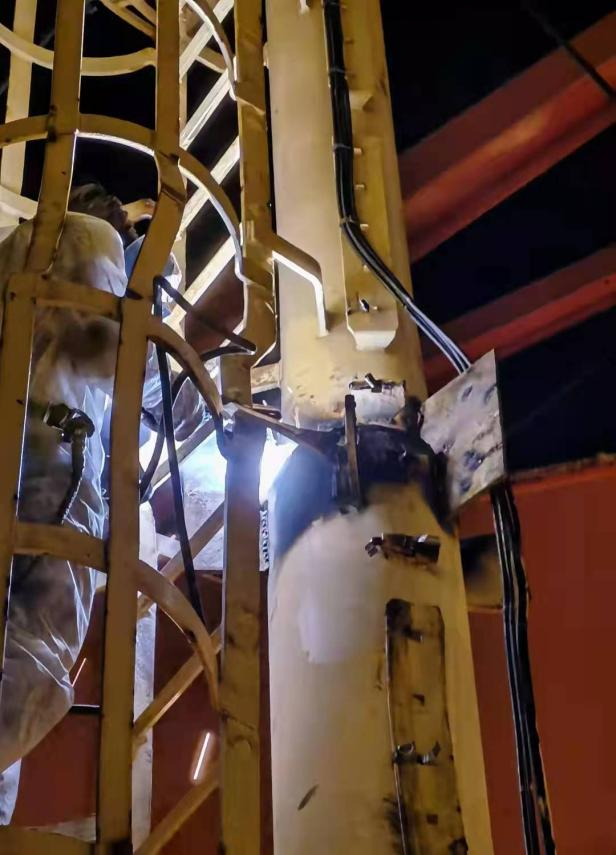

At 00:40, the welding of the mast is finished, repair the base of

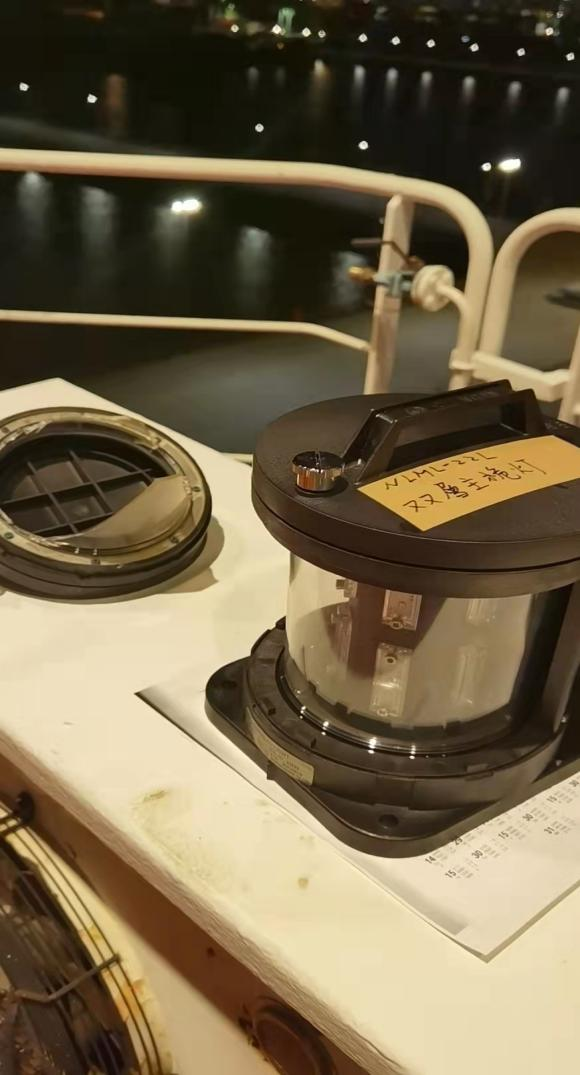

the navigation lights and replace the new navigation lights as
required by the ship, otherwise the captain refuses to sail; Our
engineer urgently repaired the base of the navigation lights, and
simply followed the navigation and told the ship to strengthen the
navigation lights in the daytime; 01:30 The pilot boarded the
ship, and our engineer got off the ship. The isolation vehicle had
been waiting for us. We boarded the vehicle for closed-loop
management and entered the seamen's hotel for isolation.
label:

1. There is no deformation in the lower part of the mast, and the
direction of the mast is broken
2. Deformation occurs at the broken part of the mast, and the
direction is the broken direction of the mast

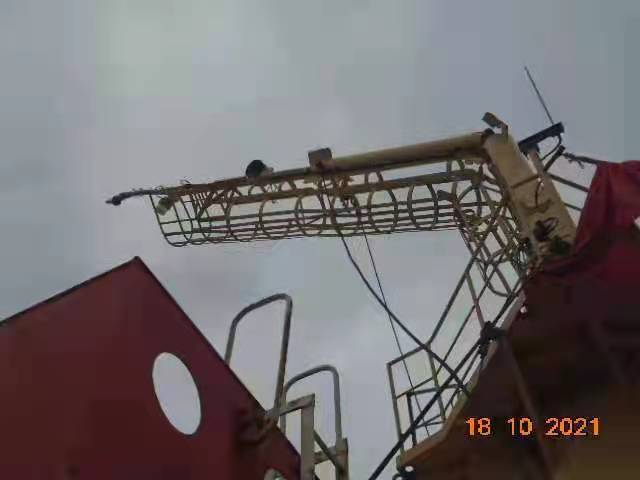

Before the repair
After the repair
Before and after repair, as shown in the picture above, approved
by ship owner and captain;
The ship sails smoothly as scheduled!
